Sterilization Validation 101: What's Required, How Long It Takes, and How to Plan for It
Once ethylene oxide has been identified as the preferred sterilization modality (if not yet determined, this resource may helpLink), the next challenge is validating it. This is where many teams underestimate scope. A first time validation can run three to five months once bioburden testing, cycle development, and qualification runs are factored in, and that timeline sits directly on your critical path to a 510(k) clearance.
This guide breaks down what ETO sterilization validation actually requires, how long each phase typically takes, and how to plan your program so it doesn't become the bottleneck standing between your device and the market.
What Validation Actually Proves
ISO 11135 governs the development, validation, and routine control of ethylene oxide sterilization for medical devices. Validation exists to provide documented, repeatable evidence that your process consistently achieves the required sterility assurance level (SAL), typically 10 to the negative 6 for medical devices. It's not a single test. It's a structured program tying bioburden data, cycle parameters, and qualification runs together into one auditable package.
The Three Phases: IQ, OQ, and PQ
Every ETO validation is built around three qualification stages.
Installation Qualification (IQ): Confirms the sterilization chamber and supporting equipment are installed correctly and match specifications, including calibration of gas concentration, humidity, temperature, and vacuum controls. Performed by the contract sterilization supplier when the final equipment installation is completed and conducted only by the contract sterilizer prior to the OQ
Operational Qualification (OQ): Confirms the empty chamber operates within its defined parameters across the intended range, without product load. This maps gas concentration, humidity, and temperature distribution throughout the chamber. Performed by the contract sterilization supplier when the final equipment installation and conducted only by the contract sterilizer prior to the MPQ
Performance Qualification (MPQ): Confirms the cycle works with actual product loaded, under worst case conditions. The microbiological performance (MPQ) qualification using Process Challenging Device containing biological indicators (PCDs) and a physical performance qualification using data loggers to confirm temperature and humidity
Additionally, a minimum of 2-3 full validated cycle must need to be performed to deploy product samples Ethylene Residuals studies.
PQ is typically the longest phase, since it requires multiple full scale, product loaded runs before a cycle can be considered validated, and worst case loading configurations often need to be established first.
Bioburden Testing Comes First
Before cycle development can begin, you need to know what you're sterilizing against. Bioburden testing, per ISO 11737 1, quantifies the population of viable microorganisms present on your device before sterilization, and this data directly informs cycle development.
A few things worth planning around early:
Bioburden testing is typically run as a campaign across multiple lots, not a single batch, since microbial load naturally fluctuates between production runs.
A minimum of three representative lots is generally recommended to establish a defensible baseline.
Skipping or underscoping this step is one of the most common causes of mid validation surprises, including cycle failures that send teams back to protocol development.
How Long Does It Actually Take
Once validated, ETO processes require ongoing routine monitoring and requalification to confirm the process stays in a validated state, particularly whenever product, packaging, or load configuration changes.

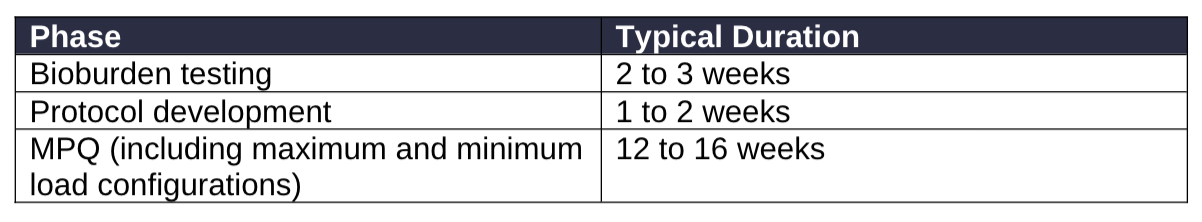

Altogether, an initial validation typically runs 12 to 16 weeks from cycle development through completed MPQ, before accounting for report writing, internal quality review that may take another 2-4 weeks.
Where Timelines Slip
A few patterns show up repeatedly and are worth planning around, echoing themes we'vewritten about before when it comes to complex device sterilization:
Underestimating load configuration scope. Teams sometimes plan for a single PQ run when device geometry or packaging density requires multiple worst case configurations.
Discovering material incompatibility mid validation. A material compatibility assessment during method selection prevents this, but it's frequently skipped in the interest of speed.
Treating bioburden as an afterthought. Since cycle development depends on bioburden data, delays here cascade into every later phase.
Underestimating documentation review time. FDA 510(k) submissions and EU MDR technical files expect validation reports formatted to specific standards, and rework at the review stage adds weeks that don't show up in the lab schedule.
Planning Your Validation Program
The most effective way to protect your launch timeline is to treat sterilization validation as a parallel workstream, not a final step.
Confirm your sterilization method during design, since material compatibility and device geometry both influence cycle feasibility.
Schedule bioburden testing well ahead of your target validation start date. It's a prerequisite, not something that runs concurrently with protocol development.
Build in buffer time for report writing and internal quality review, not just chamber time.
Confirm chamber availability with your sterilization provider early. Scheduling constraints at contract sterilization facilities are a common and avoidable source of delay.
The Bottom Line
Sterilization validation is not a step to schedule at the end of your project timeline. It's a multi phase program with real lead times, starting with bioburden testing and ending with documented, audit ready PQ data. Building it into your plan early, and understanding where delays typically originate, is the difference between validation as a routine milestone and validation as the reason your launch slips.
At PiSA USA, cycle development, parametric release, and full-scale ETO processing happen under one roof and one quality system, so validation runs alongside manufacturing rather than waiting behind it. Learn more about our in house sterilization capabilities or contact us to talk through your validation timeline.
